Current Projects
Please check here for the latest information on proposed projects!
- Mountrail Phase II & III
- 1.14.25 Mountrail Phase II consisted of putting in a transmission line and booster station. This project is completed. Mountrail Phase III is the rural expansion from the Phase II infrastructure. This is going out to bids this winter. We had many delays on this project including getting the water purchase agreement finished with the City of Parshall and approved by the NDDEQ, easement acquisition, and issues with new requirements from the ND SHPO Office that required additional archaeological survey. Once we have a contract awarded, we will give the contractor 2 construction seasons to complete the project.
- 3.21.25 Bid Opening for Project
- 3.21.25 Bid was awarded to Abbott, Arne, Schwindt, Inc. Out of Moorhead, MN.
- Pre-Construction meeting-June
-
7.31.25, Mountrail Phase III project has approximately 123.5 total miles of pipe that will serve 128 new customers.
Of that 123.5 miles there is about 10 miles of pipe that is in the ground. Which puts the project 8% complete.

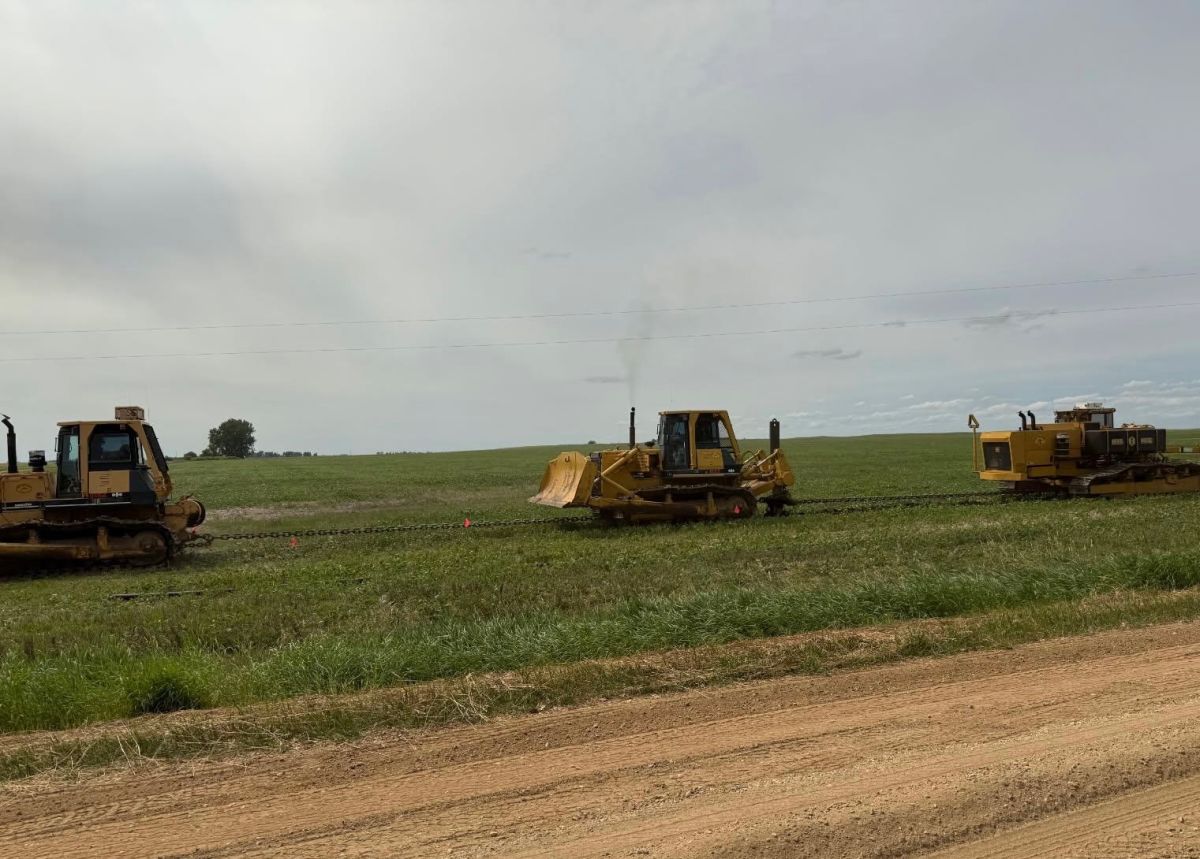

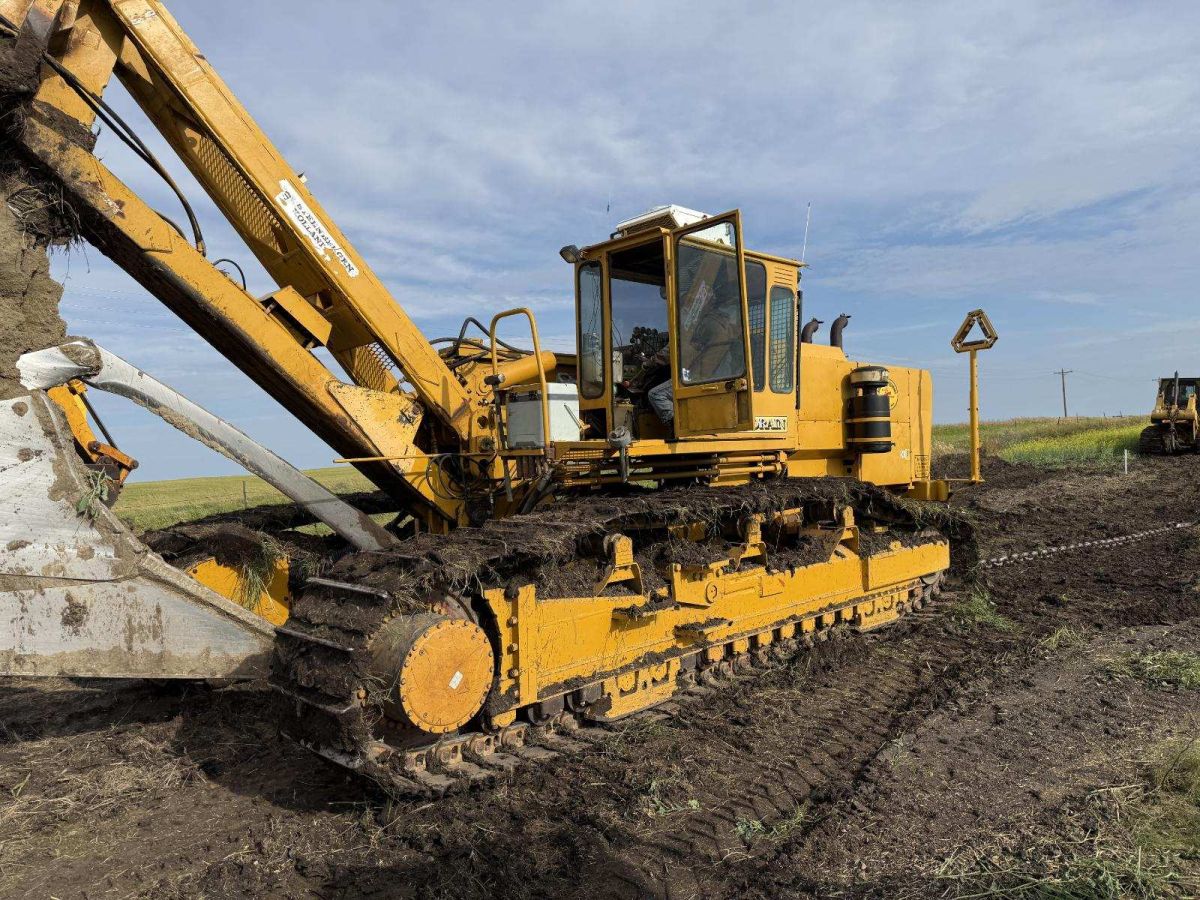

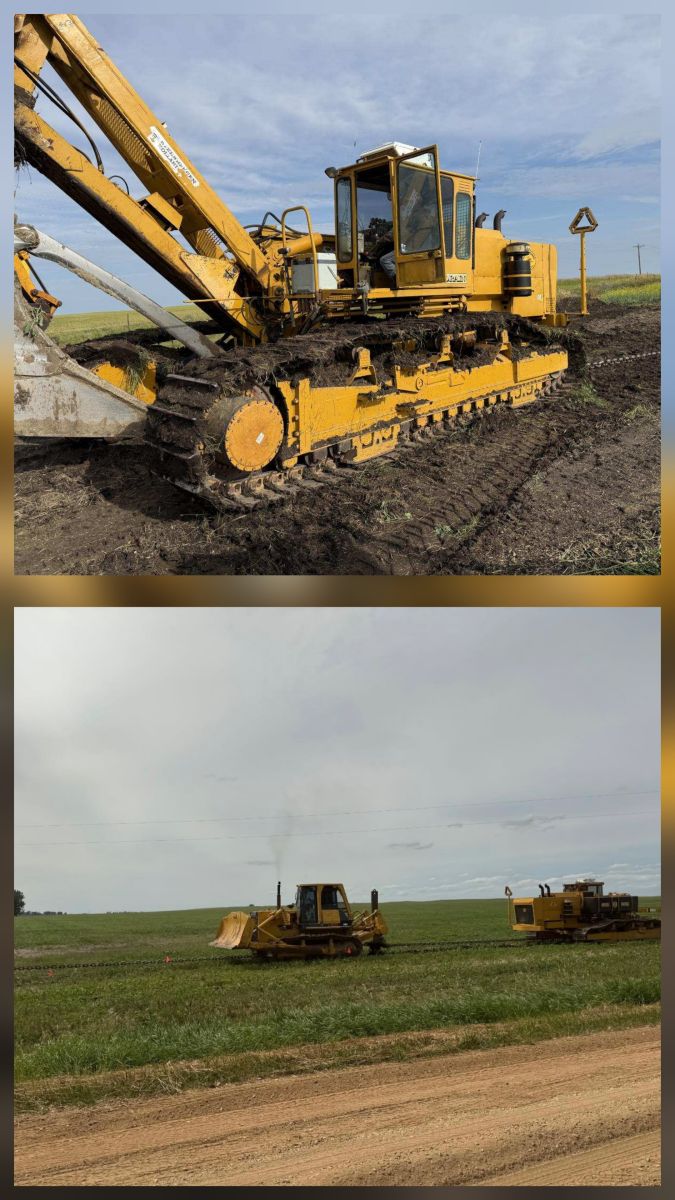

Crews are currently working in Spring Coulee Township North of Plaza and will continue working North into Oakland, Osloe and Kickapoo Townships. The mainline work will be completed in approximately 3 weeks (August 20th) in this area.
In 3 weeks (August 20th) mainline work will begin in Shealy, Tolgen, and Mandan Townships. The main line work for these townships will be completed in approximately 4 weeks (September 17th)
Water will not be available until October in these areas.
This is a construction schedule that can change depending on the weather. We will update the timeline as the construction season progresses.
Of that 123.5 miles there is about 10 miles of pipe that is in the ground. Which puts the project 8% complete
